Spring 2025 Progress

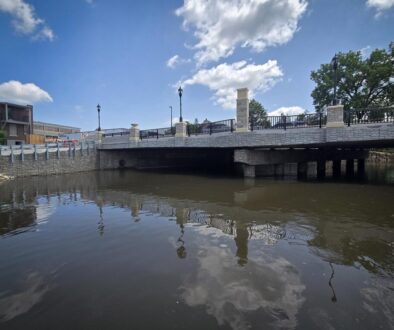

Dunnet Bay has constructed the west half of the bridge deck latex concrete overlay to serve as the final driving surface on the bridge. They have also constructed the monuments on the NW & SW corners of the bridge. A Horn has completed construction of the monuments along the west side of the bridge. JG Demo has constructed sidewalks and driveways along the north side of Aurora Ave and west side of Washington St. Hecker and Company have begun to install the lighting along the west side of Washington St. Geneva Construction has constructed the remaining HMA base course on Washington St, north of the bridge. Traffic on Washington St is scheduled to be switched to the west half of the bridge on May 6th in order to construct the sidewalk, traffic barrier, and monuments along the east side of the bridge.
Percent Completion = 78%
